OSOM deliveries

Home » About Us » OSOM deliveries

OSOM deliveries

Oversize overmass (OSOM) deliveries for the Lotus Creek Wind Farm are underway.

Most of the deliveries will be wind turbine components, along with a small number of ancillary equipment such as transformers and switch rooms.

The Lotus Creek Wind Farm is committed to delivering these OSOM components safely and to minimising the impact on local communities.

OSOM deliveries are expected to continue for approximately 12 months. We will continue to update this page as the delivery schedule is confirmed.

vestas lotus creek wind farm who we are
vestas lotus creek wind farm who we are

Refer below for the delivery schedule. The schedule may change due to weather or operational conditions.

Example of a wind tower section delivery

Delivery schedule for turbine components

Lotus Creek Wind Farm OSOM delivery schedule for 12 to 20 September 2026
Delivery date Port of Gladstone to Marlborough Marlborough to Lotus Creek Wind Farm Gladstone to Lotus Creek Wind Farm
Saturday 12th of September Departs 12:05 am Arrives 6:30 am No scheduled delivery Departs 12:05 am Arrives 7:00 am
Sunday 13th of September No scheduled delivery No scheduled delivery No scheduled delivery
Monday 14th of September Departs 12:05 am Arrives 6:30 am Departs 3:30 am Arrives 7:00 am Departs 12:05 am Arrives 7:00 am
Tuesday 15th of September Departs 12:05 am Arrives 6:30 am Departs 3:30 am Arrives 7:00 am Departs 12:05 am Arrives 7:00 am
Wednesday 16th of September Departs 12:05 am Arrives 6:30 am No scheduled delivery Departs 12:05 am Arrives 7:00 am
Thursday 17th of September Departs 12:05 am Arrives 6:30 am Departs 3:30 am Arrives 7:00 am Departs 12:05 am Arrives 7:00 am
Friday 18th of September Departs 12:05 am Arrives 6:30 am Departs 3:30 am Arrives 7:00 am Departs 12:05 am Arrives 7:00 am
Saturday 19th of September Departs 12:05 am Arrives 6:30 am Departs 3:30 am Arrives 7:00 am No scheduled delivery
Sunday 20th of September No scheduled delivery No scheduled delivery Departs 12:05 am Arrives 7:00 am

OSOM delivery route

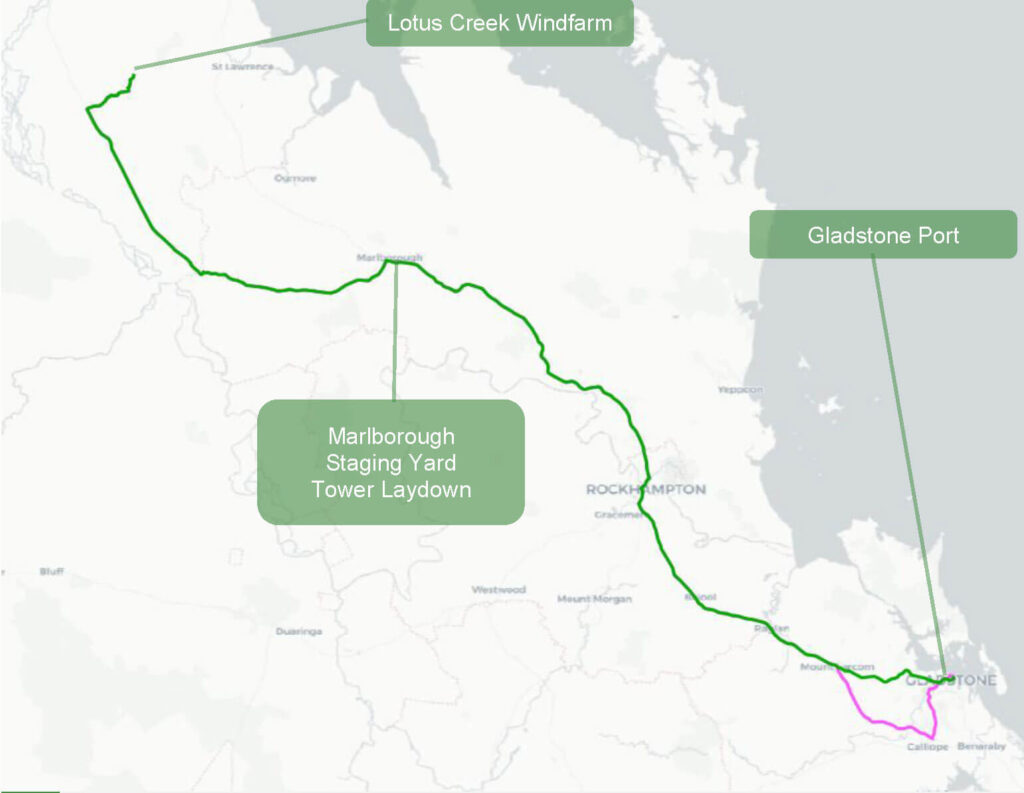

Turbine route map

Delivery schedule for transformer delivery

Tuesday 23 June - 10:00 pm

Depart Port of Brisbane

Tuesday 23 June - 10:00 pm

Wednesday 24 June - 9:00 am

Arrive at Taroom

Wednesday 24 June - 9:00 am

Thursday 25 June - 6:00 am

Depart Taroom

Thursday 25 June - 6:00 am

Thursday 25 June - 12:00 pm

Arrive at Emerald

Thursday 25 June - 12:00 pm

Friday 26 June - 6:00 am

Depart Emerald

Friday 26 June - 6:00 am

Friday 26 June - 11:00 am

Arrive Nebo

Friday 26 June - 11:00 am

Saturday 27 June - 4:00 am

Depart Nebo

Saturday 27 June - 4:00 am

Saturday 27 June - 12:00 pm

Arrive at Marlborough

Saturday 27 June - 12:00 pm

Sunday 28 June - 6:00 am

Depart Marlborough

Sunday 28 June - 6:00 am

Sunday 28 June - 1:30 pm

Arrive at Lotus Creek Wind Farm

Sunday 28 June - 1:30 pm

Transformer delivery

A 137 tonne transformer will be transported from the Port of Brisbane to Lotus Creek Substation, St Lawrence Croydon in June 2026.

We are working with the Department of Transport and Main Roads to finalise the date for this OSOM delivery. Once dates are confirmed, we will update the table below with more information.

More information

Up-to-date information about all OSOM transport movements for residents and visitors can be accessed by:

  • signing up for SMS messages on your mobile and /or subscribing to our newsletter by completing the form.
  • accessing TMR’s latest traffic conditions by phoning 13 19 40 or visiting www.qldtraffic.qld.gov.au

If you have any questions, please contact the project on 1800 979 786 or email  info@lotuscreekwindfarm.com.au.
